Introduction
Prepare your site for ready-mixed concrete delivery by ensuring access, space, and timing are ready for a smooth placement.
In this guide you’ll learn how to assess site readiness, coordinate deliveries, and apply practical tips to prevent delays and rework.
Key takeaways
- Verify site grade, slope, and drainage before any formwork or concrete work.
- Schedule pour windows to align with weather and truck availability.
- Calculate bulk concrete volumes with waste margin and aisle clearance.
- Ensure truck access, turning radii, and clearance from structures and utilities.
- Install formwork plumb, level, and securely tied to prevent leaks.
- Verify reinforcement, embeds, and utilities are correctly placed before pour.
Table of Contents
- Introduction
- Key takeaways
- Why Proper Preparation Matters
- Pre-Pour Planning and Scheduling
- Calculating Quantity and Choosing the Right Mix
- Site Access and Truck Logistics (Clearance & Turning Radius)
- Clearing, Excavation and Subgrade Preparation
- Formwork Installation and Layout
- Reinforcement, Embeds and Utilities
- Tools, Equipment and Crew Organization
- Receiving and Inspecting the Delivery
- On-Site Safety and PPE
- Weather Considerations and Seasonal Curing Strategies

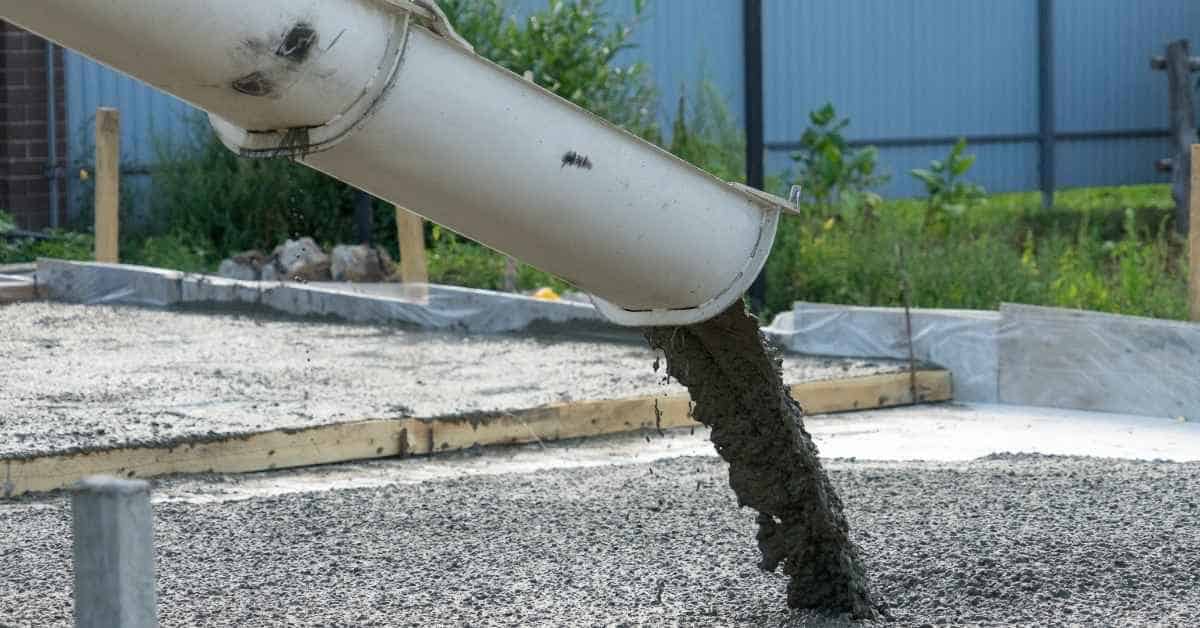

- Concrete Pumping vs Truck Chute vs Wheelbarrow
- Final Pre-Pour Checklist (Day Before & Morning Of)
- Pouring, Finishing and Testing Procedures
- Immediate Post-Pour Care and Curing
- Cleanup, Waste Management and Truck Departure
- Common Mistakes, Troubleshooting and Corrective Actions
- Cost Guidance, Ordering Strategy and Contract Tips
- Legal, Permits and Local Compliance Considerations
- Visual Checkpoints and Site Diagrams to Reduce Risk
- Post-Pour Maintenance and When to Call a Pro
- Ready-Mix Delivery Day Communication Template
- Quick Reference Tools & Checklists
- Conclusion
- FAQ
Why Proper Preparation Matters
Proper site preparation sets the foundation for concrete quality by controlling base moisture, ensuring a clean, uncompacted subgrade, achieving proper compaction and formwork alignment, and preventing laitance or dust that can weaken the pour. It also drives the project schedule and cost, because lead times for subbase, forms, rebar, and ready-mix deliveries must be coordinated with weather, site access, and the need for a clean, stable window on pour day. Common failure modes—laitance, settlement, frost heave, improper moisture, and contamination—often trace back to inadequate prep, and they are best avoided through practical detectors, moisture tests, and timely remedies.
A concise pre-pour plan helps you catch issues early and reduce rework by confirming subbase moisture, verifying forms and rebar readiness, ensuring mixer access, and establishing dust control and safe drainage, including how moisture tests were performed and the outcomes. Safety and regulatory considerations matter too: ensure stable access, trench edge protection, drainage plans, erosion control, and coordination with authorities or inspectors for drainage, utilities, and permit requirements. Documenting prep work with photos and notes creates a reliable record for the delivery crew and future maintenance, supports accountability for quality, and helps guide adjustments if conditions change for future audits.
Risks of Poor Preparation
Poor prep shows up fast on pour day. Uneven or contaminated subgrade and excessive dust lead to segregation and weak surfaces that crack or spall within weeks. Improper compaction or soft spots let slabs settle or heave later, creating trip hazards and costly repairs.
Delivery can be delayed or refused if access, forms, or reinforcement aren’t ready. That wastes ready-mix time, adds haul-back charges and forces rushed fixes that compromise quality. Weather and drainage issues magnify these problems and increase the chance of rework.
Expect added cost from wasted material, extra labor, and potential replacement of damaged subbase. A quick check for contamination, moisture and form integrity prevents most of these failures.
Benefits of a Well-Prepared Site
A tidy, stable site makes the pour predictable. When forms, compaction, and moisture control are correct you get faster placements and fewer stops. That reduces truck waiting time and keeps the mix within its design window.
Good prep limits rework and waste. Accurate subbase checks and clear access let you order the right quantity and sequence, saving money on overages and haul-back fees. Consistent compaction and clean reinforcement ensure the slab performs as intended.
Preparation also improves safety. Clear routes for mixers, proper slope and drainage, and dust control protect crews and neighbors. Documenting prep with photos and notes helps communicate expectations to the delivery crew and inspectors.

Pre-Pour Planning and Scheduling
Pre-pour planning sets the schedule and logistics for a concrete pour, ensuring materials arrive when the crew needs them and avoidable delays are minimized. Plan orders 2–7 days in advance based on project size and supplier policy, build in buffers for weekends and holidays, and confirm minimums, backorder policies, and any potential changes to the requested mix designs. Identify ideal delivery windows, prefer cooler morning hours, align with pour rate and crew availability, and plan staggered deliveries for multiple pours to prevent bottlenecks.
For a DIY or jobsite, this forethought translates into fewer trips, safer workflows, and a smoother sequence from formwork to finish. Keep a site readiness checklist in view: complete formwork, secure reinforcement, verify subgrade moisture and compaction, place joints correctly, and ensure unobstructed truck access and a clean, level staging area. Meanwhile, plan for permits, access, traffic, and a weather contingency so you can reschedule with the supplier without scrambling, reducing downtime and protecting your timeline.
How Much Lead Time to Give Your Supplier
For small pours (single yard or two) call 2–3 days ahead. For medium jobs (driveways, patios) book 3–5 days. Large pours or specialty mixes need 5–7 days. That gives the plant time to schedule trucks and reserves your mix.
Always check with your plant for their minimums and weekend policies. Ask if same-day or short-notice deliveries are possible and what fees apply. Confirm your mix design and any admixtures before the cut-off to avoid substitutions on delivery day.
Choosing Delivery Time for Best Conditions
Morning deliveries are usually best. Cooler temperatures slow initial set and help finishing. Early runs also avoid peak traffic and give your crew the whole day to place and finish the concrete.
If you must pour in the afternoon, plan for higher temps and faster set—use retarder admixtures or extra hands. Match delivery rate to your crew’s placement speed and allow for staggered trucks so you don’t sit waiting for equipment or space.
Permits, Noise and Neighbour Notifications
Check local requirements for street closures, truck access permits, and working-hour restrictions. Some municipalities require road-use approval for large trucks or oversize loads. Get permits well before the pour to avoid last-minute delays.
Tell neighbours or site managers the delivery window and likely noise. A simple notice avoids complaints and allows them to move cars or expect truck movements. Coordinate access, height and width clearances with suppliers so trucks can reach the site without surprises.
Calculating Quantity and Choosing the Right Mix
Accurate quantity starts with defining the project volume: measure the footprint, track thickness, stairs, and dropped areas, then convert everything to cubic yards (or cubic meters) and document a primary calculation along with a contingency buffer for spillage and on‑site losses. Use a setback margin, typically 5–10%, to the final quantity and explain how that buffer translates into additional loads, while keeping units consistent from mix design to delivery and placement. For planning, outline the target compressive strength, typical slump range for your method, and the common admixtures you might consider, so you can match performance, durability, and code requirements without overcomplicating the job.
With the numbers in hand, you gain practical guidance on formwork, placement method (truck, pump, or wheelbarrow), and finish type, which in turn shapes workability and timing. This helps you avoid waste, ensures timely delivery aligned with site readiness, and makes it easier to adjust slump and dosage using water or superplasticizers without overstressing the mix or accelerating set beyond your window. Keep a simple worksheet for unit checks, weather and temperature considerations, and a quick round of on‑site verifications to document assumptions and support a smooth, predictable pour.
Concrete Volume Math & Buffer Percentages
Measure the pour area: length × width × thickness. For footings or steps, break into rectangles or trapezoids and total them. If using inches, divide the result by 27 to get cubic yards; if using millimetres, convert to cubic metres by dividing by 1,000,000.
Always add a buffer for waste and spillage. I typically use 5–10% on flatwork and 10%+ for complex pours or deep footings. Multiply your base volume by 1.05–1.10 and round up to the next quarter yard (or 0.1 m3) when ordering to avoid coming up short.
Mix Selection: Strength, Slump, and Admixtures
Pick compressive strength to suit the job: around 3,000–4,000 psi for residential slabs, 4,000–5,000 psi or higher for driveways and structural elements. Check local code or engineer specs for critical members.
Match slump to placement: low slump (2–3″) for wheelbarrow and tough forms, higher slump for pumping or intricate finishes. Use water reducers or superplasticizers to increase workability without extra water. Add air-entraining agents for freeze-thaw exposure, accelerators for cold weather, and retarders for hot conditions. Avoid mixing incompatible admixtures—confirm with your supplier.
Cost Impact of Mix Choices and Additives
Standard mixes are cheapest. Increasing strength, adding admixtures, or specifying special aggregates raises unit price. Expect noticeable markup for high-strength, high-slump, or sp
